Rehabilitation Gotthard Base Tunnel (GBT)

In August 2023, a freight train derailment caused significant damage to the structure of the Gotthard Base Tunnel. Fortunately, no injuries occurred.

#Shortfacts

Location
Gotthard Base Tunnel, Switzerland
Construction period
October 2023 – July 2024
Client
SBB AG, Infrastruktur AEP Region Süd
Executing companies
Rhomberg Sersa Rail Group (Switzerland)

About the project

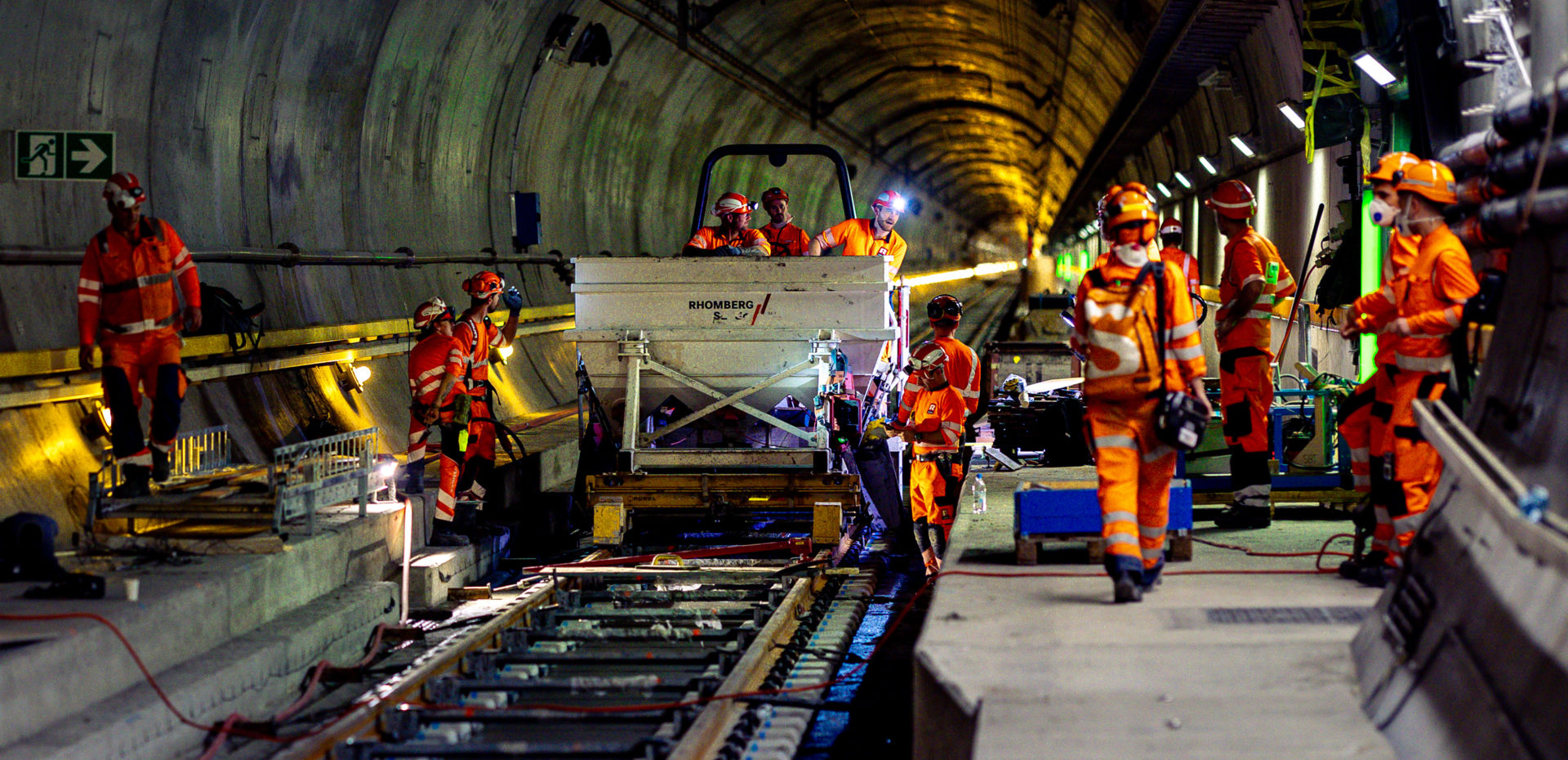

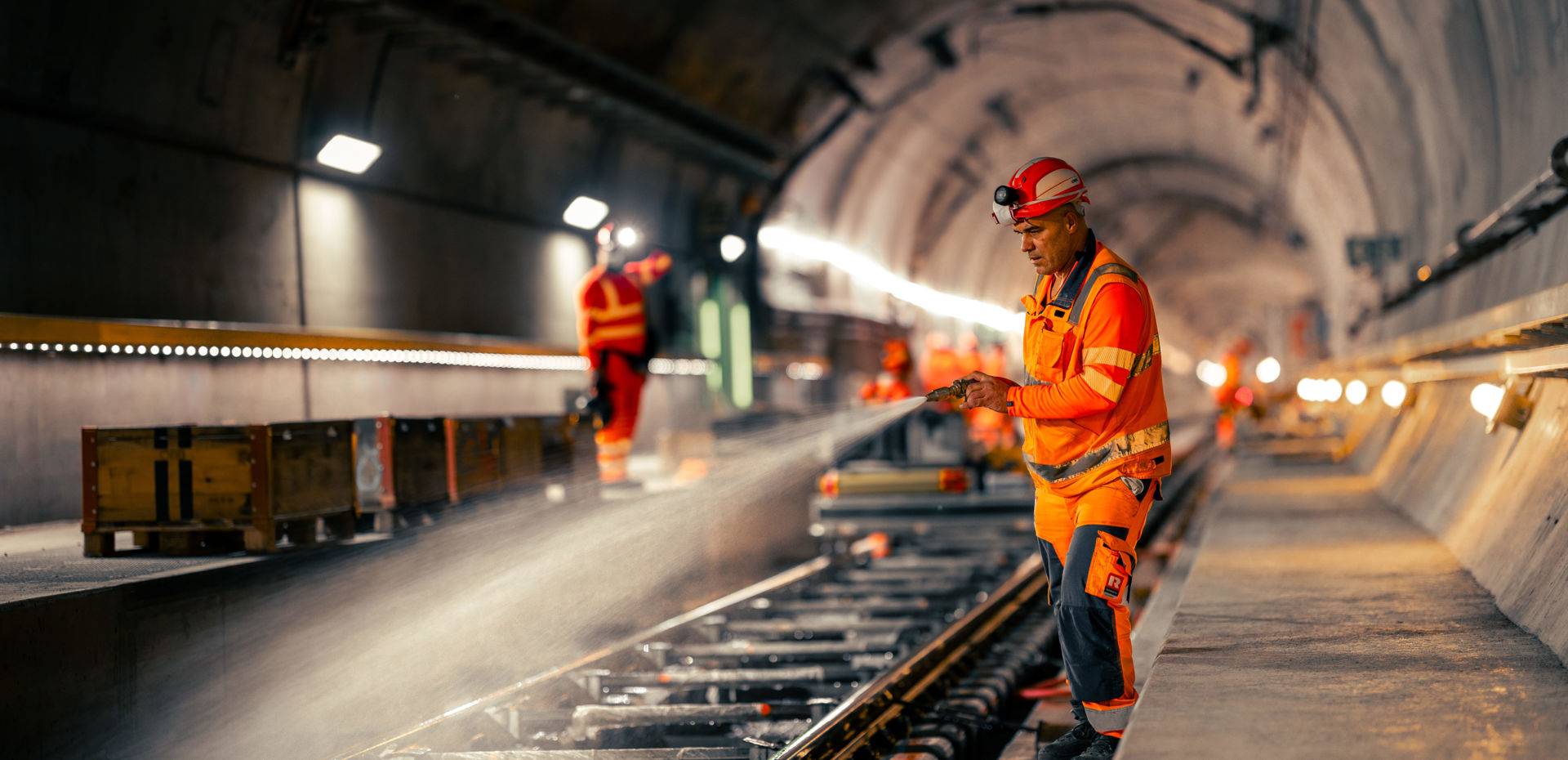

RSRG initially supported the removal of the damaged rolling stock. This was followed by the rehabilitation of seven kilometres of slab track, including the renewal of HDL inspection chambers, repair of damaged platforms and earthing systems, as well as the removal and reconstruction of two 1600-type turnouts in slab track.

Special features

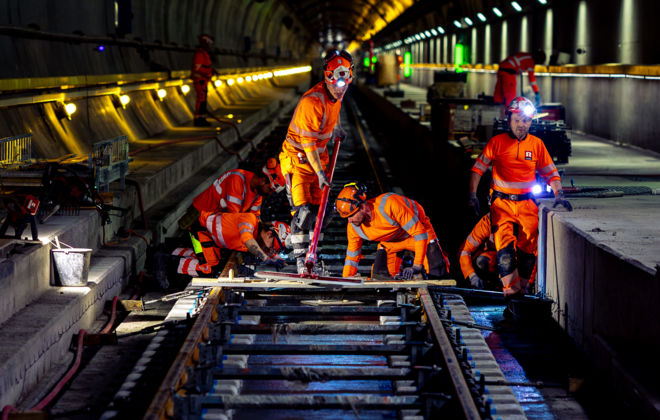

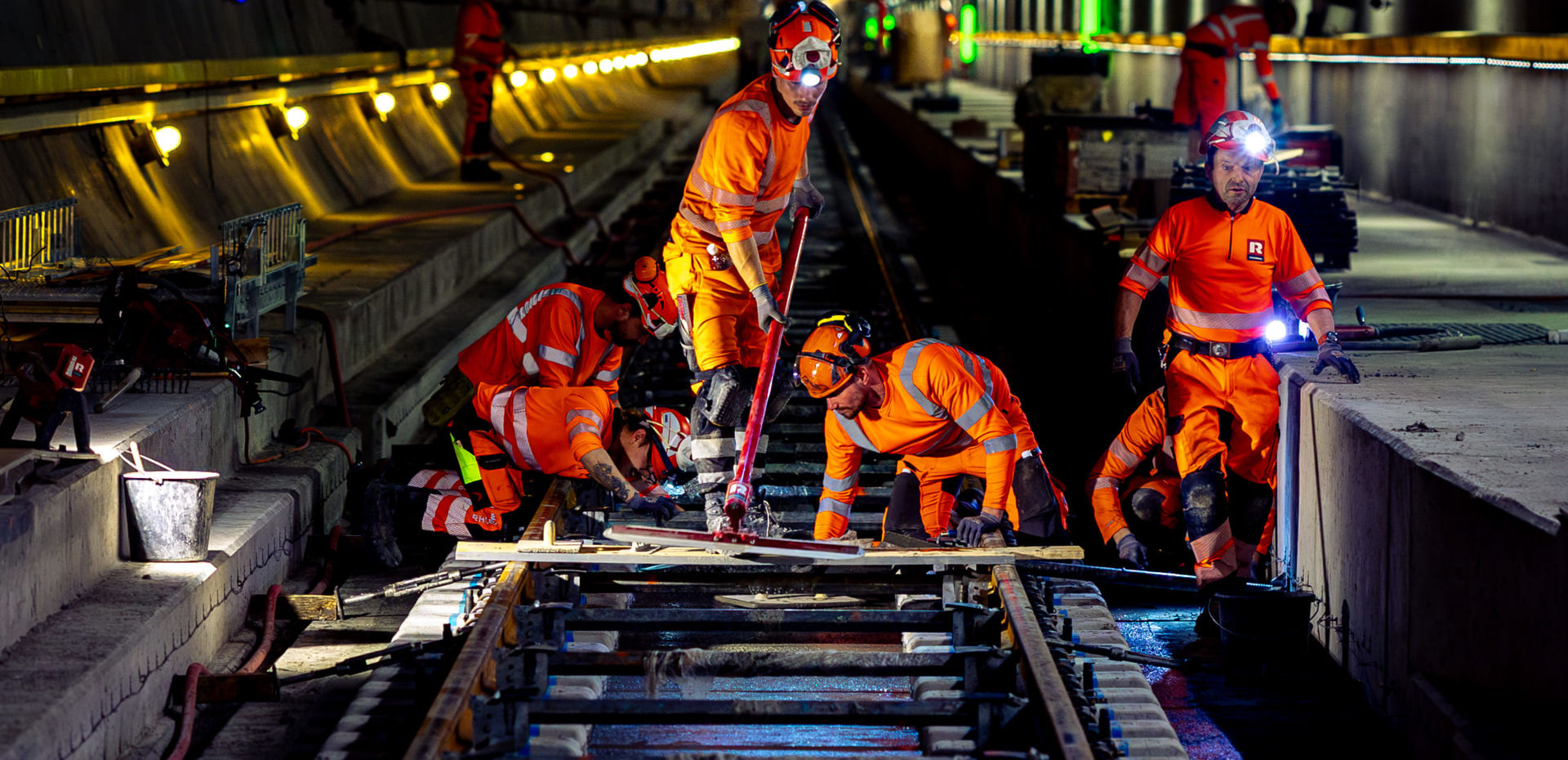

A key focus was the track removal using specialised equipment, enabling significant sections to be processed daily. These works, carried out in 18-metre track panels, were completed by the end of the first week – despite very limited preparation time, strict schedules, confined working conditions, high temperatures and challenging air quality.

Efficiency was increased through a highly coordinated shift planning approach, ensuring precise alignment of all required activities. Due to the high logistical effort, this phase represented the most time-consuming part of the project.

The commitment of the teams, their well-established collaboration and expertise, combined with strict adherence to safety protocols, were key factors in the successful delivery of this demanding project.

Key personnel

  • Project Management: Marco Mosimann, Dominko Bilic
  • Construction Management: Diego Gigirey, Sebastian Klasen, Fabijan Didak
  • Safety Management: Ivan Franciolli
  • Site Supervisors: Emanuel Figueiredo, Joel Rodrigues, Ivica Bilic
  • Surveying: Sophie Schlögl, Ali Haider, Fabrice Lardon
  • Modelling: “Digital Rail Services” team of RSRG

Technical data

  • GBT, east tube, between km 239.900 and 247.350
  • Installation and unloading of approx. 22,000 LVT supports and 14 km of SBB VI rails
  • Removal of existing track over the entire length
  • Milling of the existing concrete surface

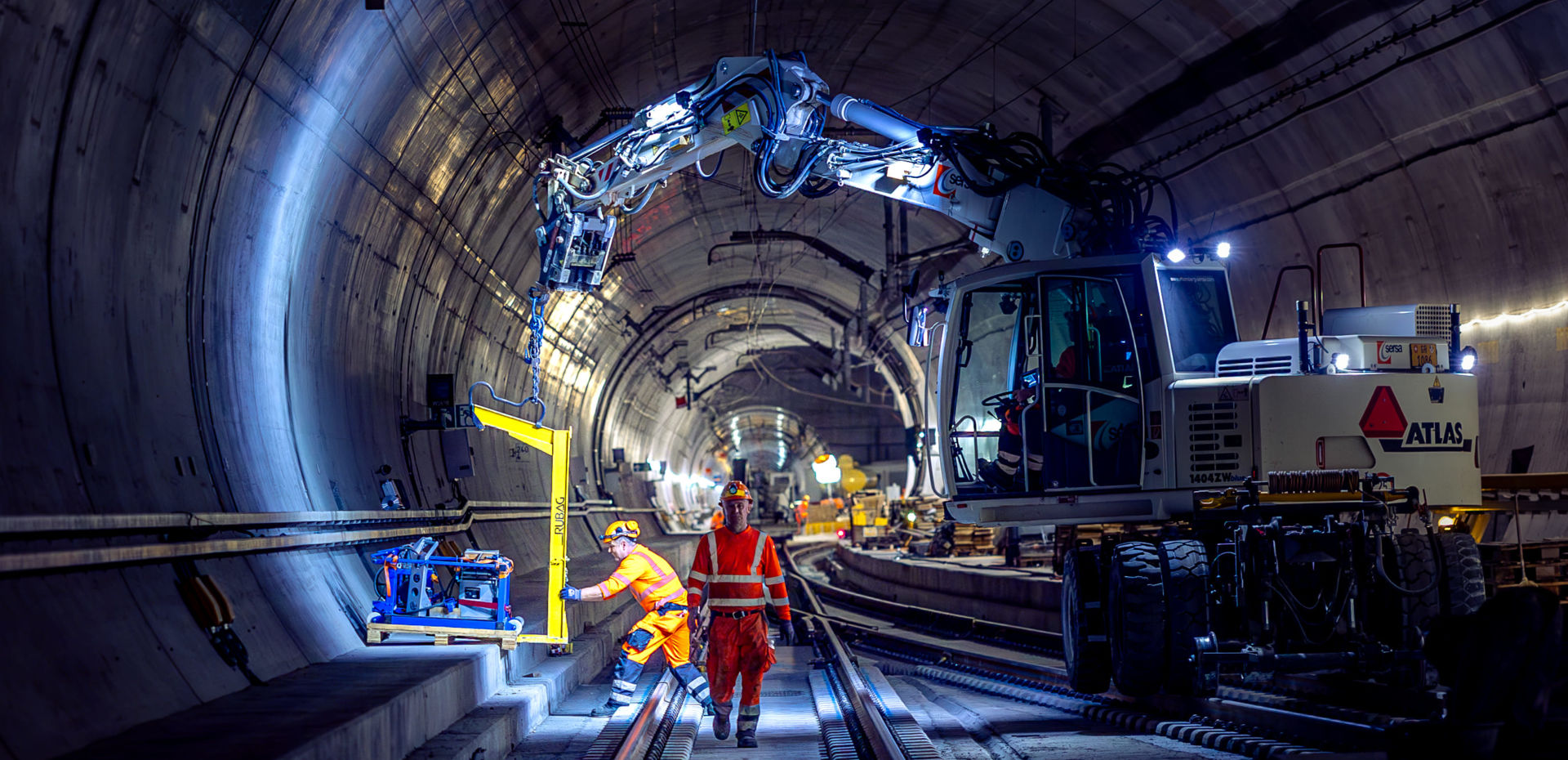

  • Installation and assembly of new track

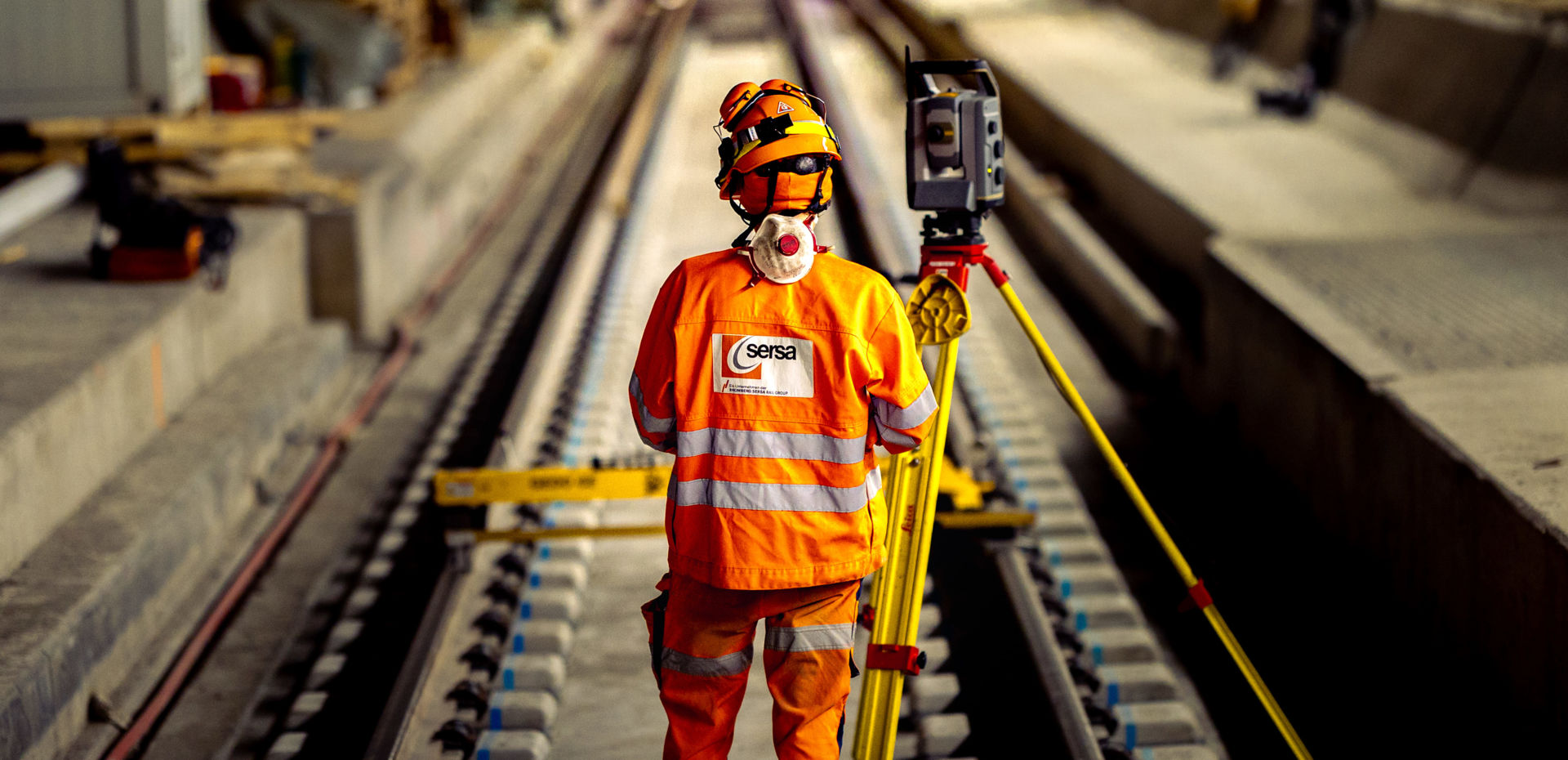

  • Track positioning and surveying
  • Concreting
  • Welding using Serstar technology

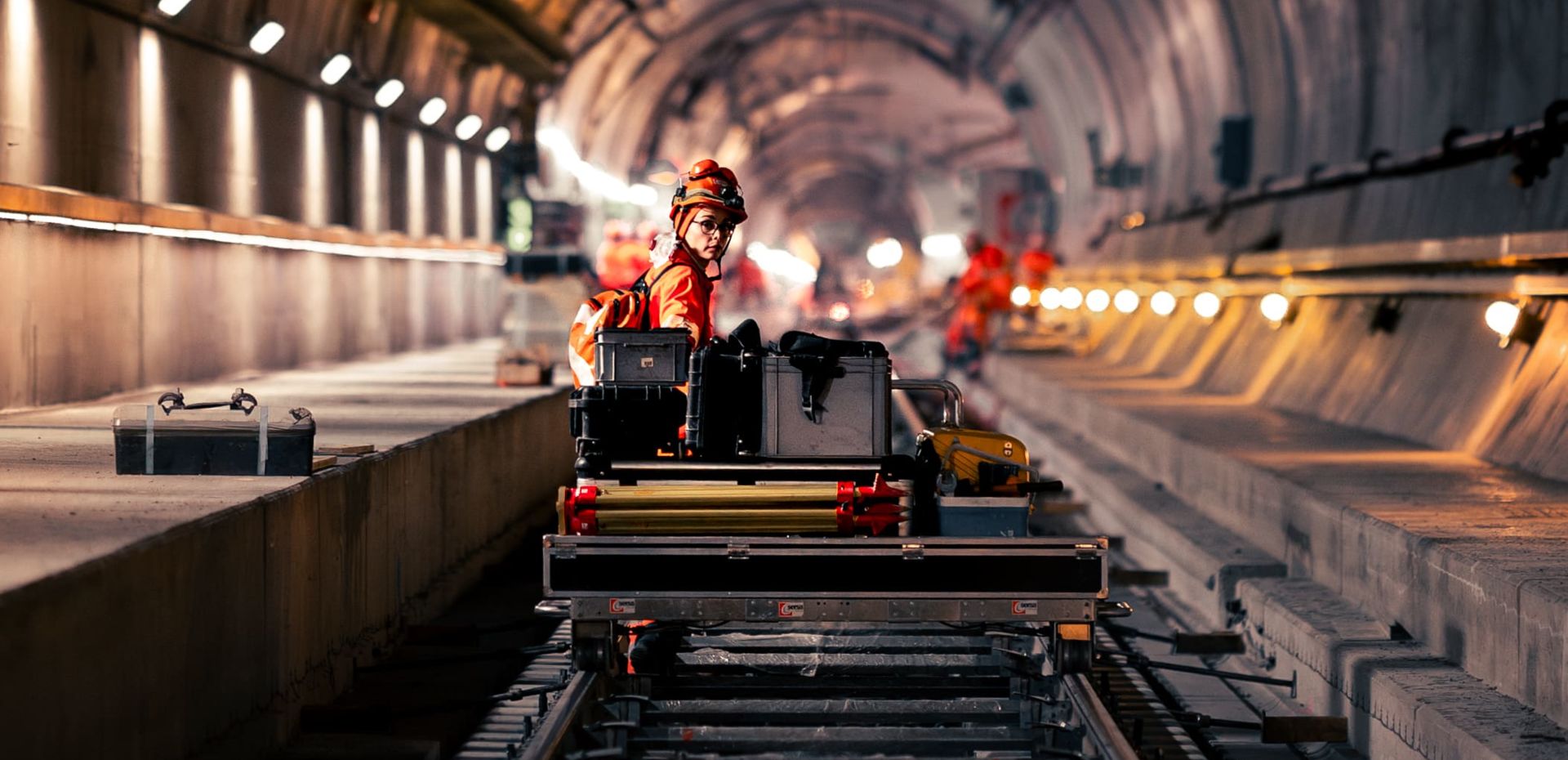

  • Laser scanning

Further articles

RSRG Successfully Involved in Renovation Work

Dedicated efforts and expertise from RSRG have led to decisive results and the successful completion of the renovation assignment in the Gotthard Base Tunnel (GBT) over the past few months, despite significant challenges.

Read the article

Repairs under extreme conditions

Following a major freight train derailment, a seven-kilometre section of slab track had to be completely refurbished – a technical challenge under the toughest conditions.

Read the article
