About the project
Scope of works for the refurbishment of the Hauenstein Base Tunnel (GU+ contract):
Construction works:

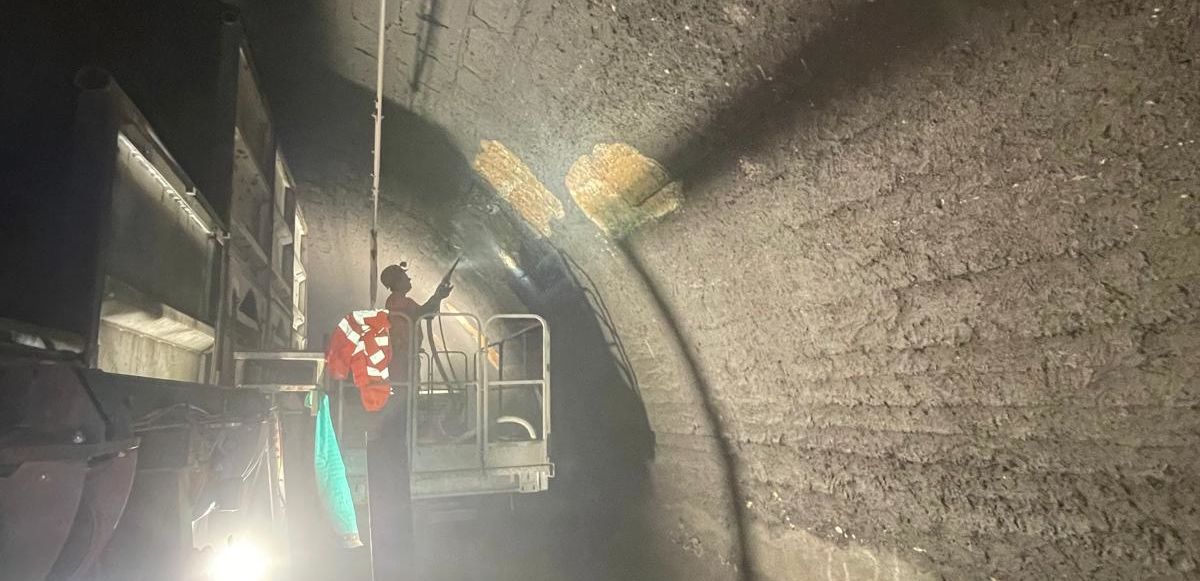

- Refurbishment of the tunnel lining in areas with significant damage

- Refurbishment of the ventilation shaft, including head and base structures

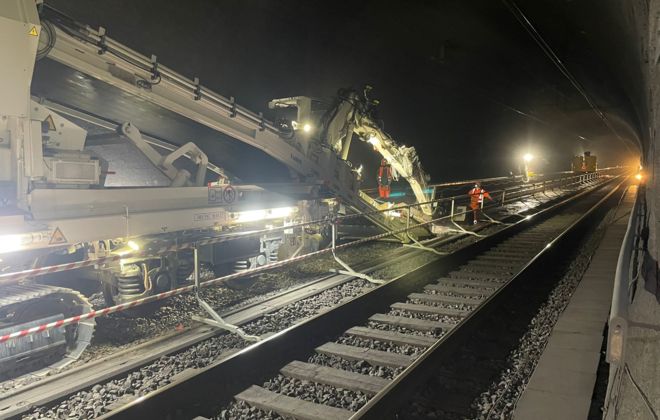

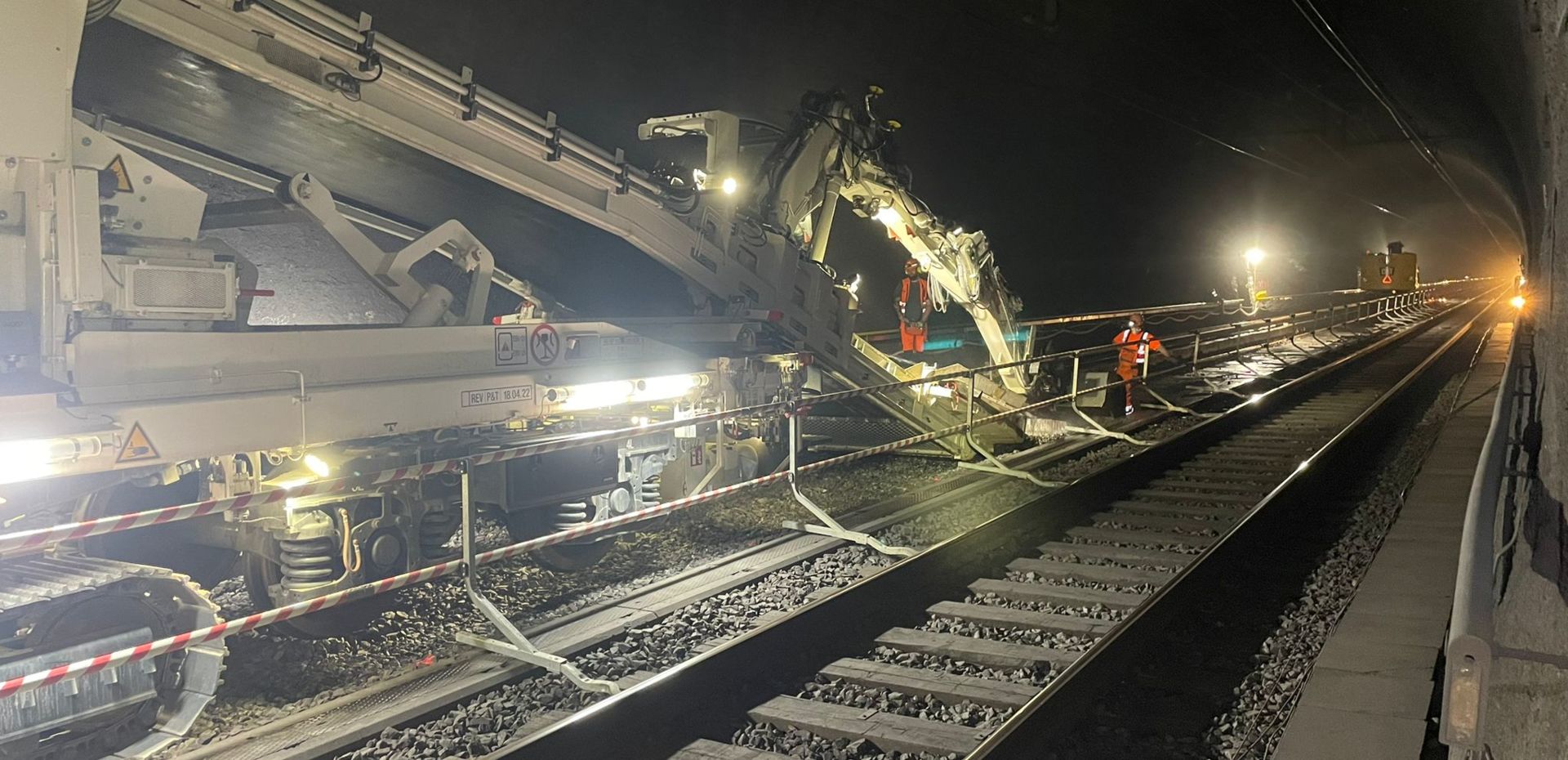

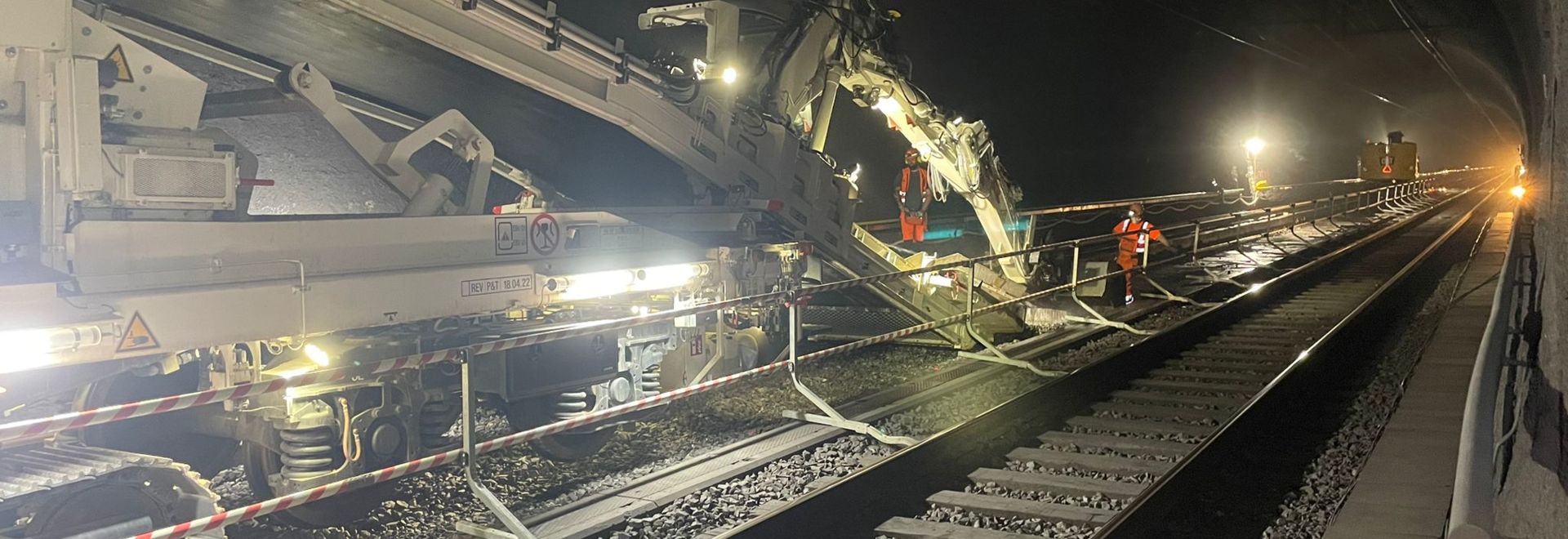

- Renewal of the track with invert lowering
- Renewal of crossovers with invert lowering
- Local refurbishment of side drainage and selected central drainage chambers

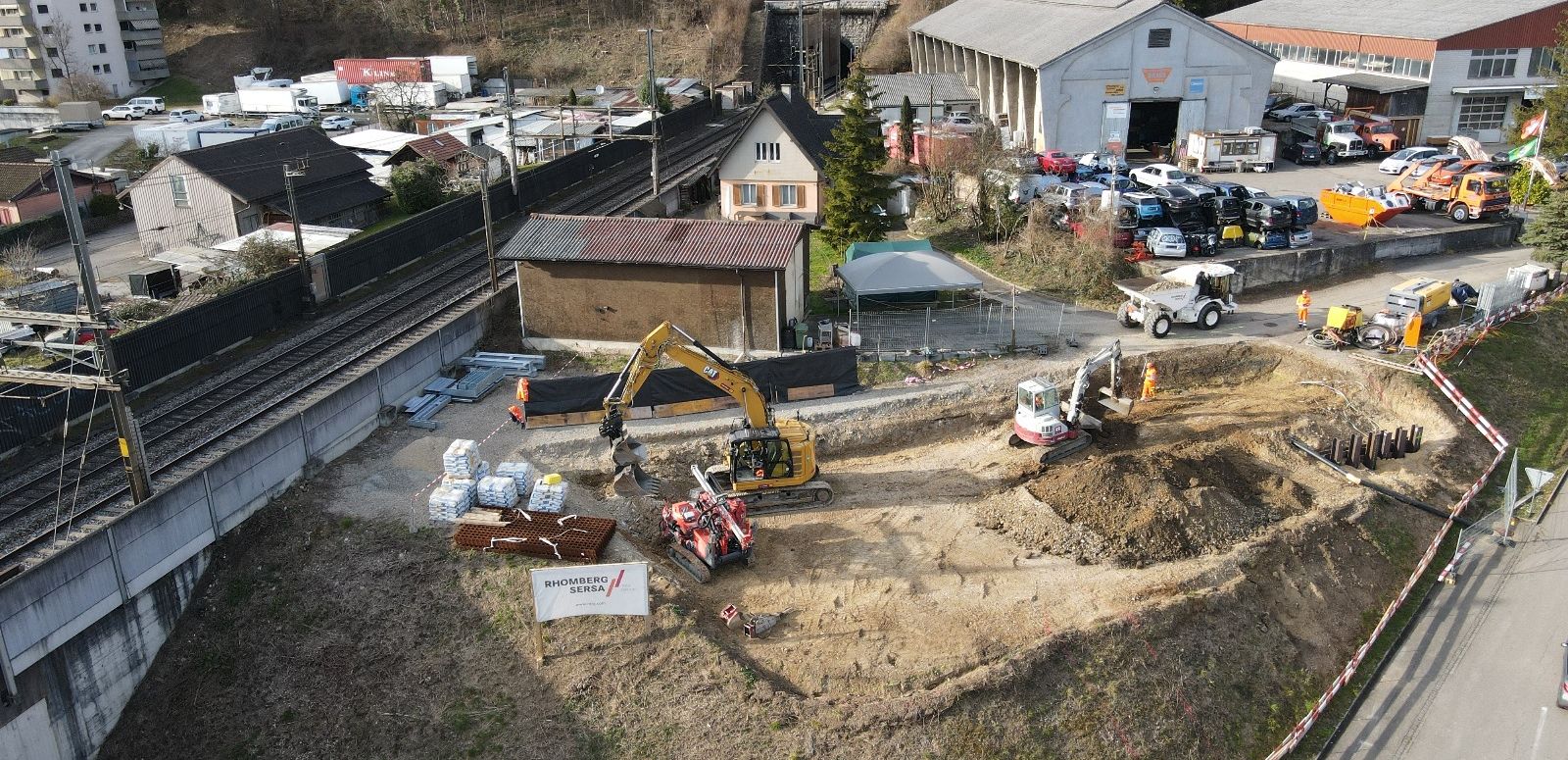

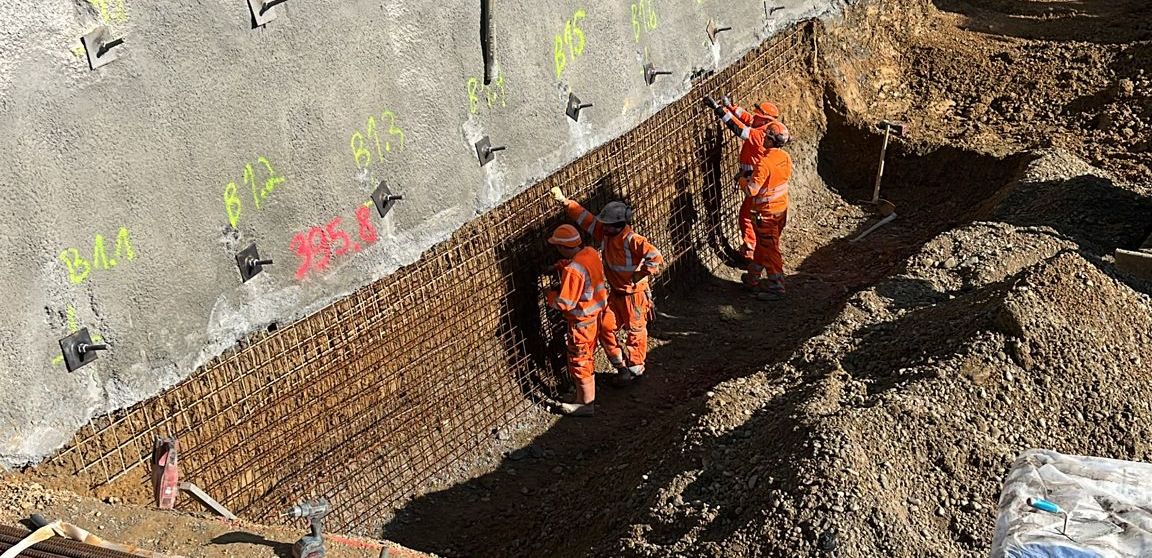

- Addition of one incident retention basin in each of the two portal areas

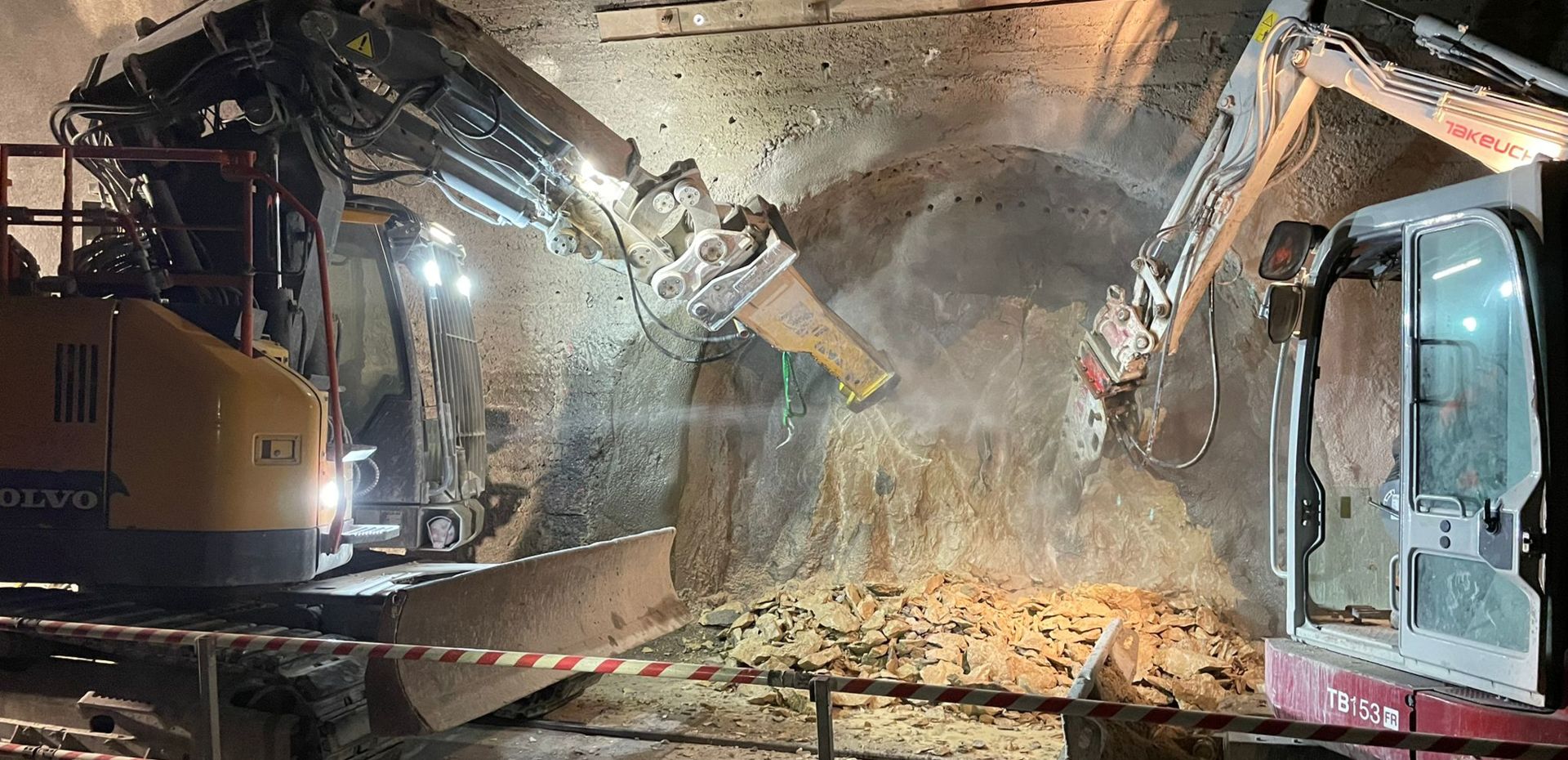

- Excavation and construction of 7 new railway service chambers
- Installation of a one-sided cable duct and redesign of the escape route on the side of track 100
- Renewal of cables, technical systems and control system (LSS – CH)

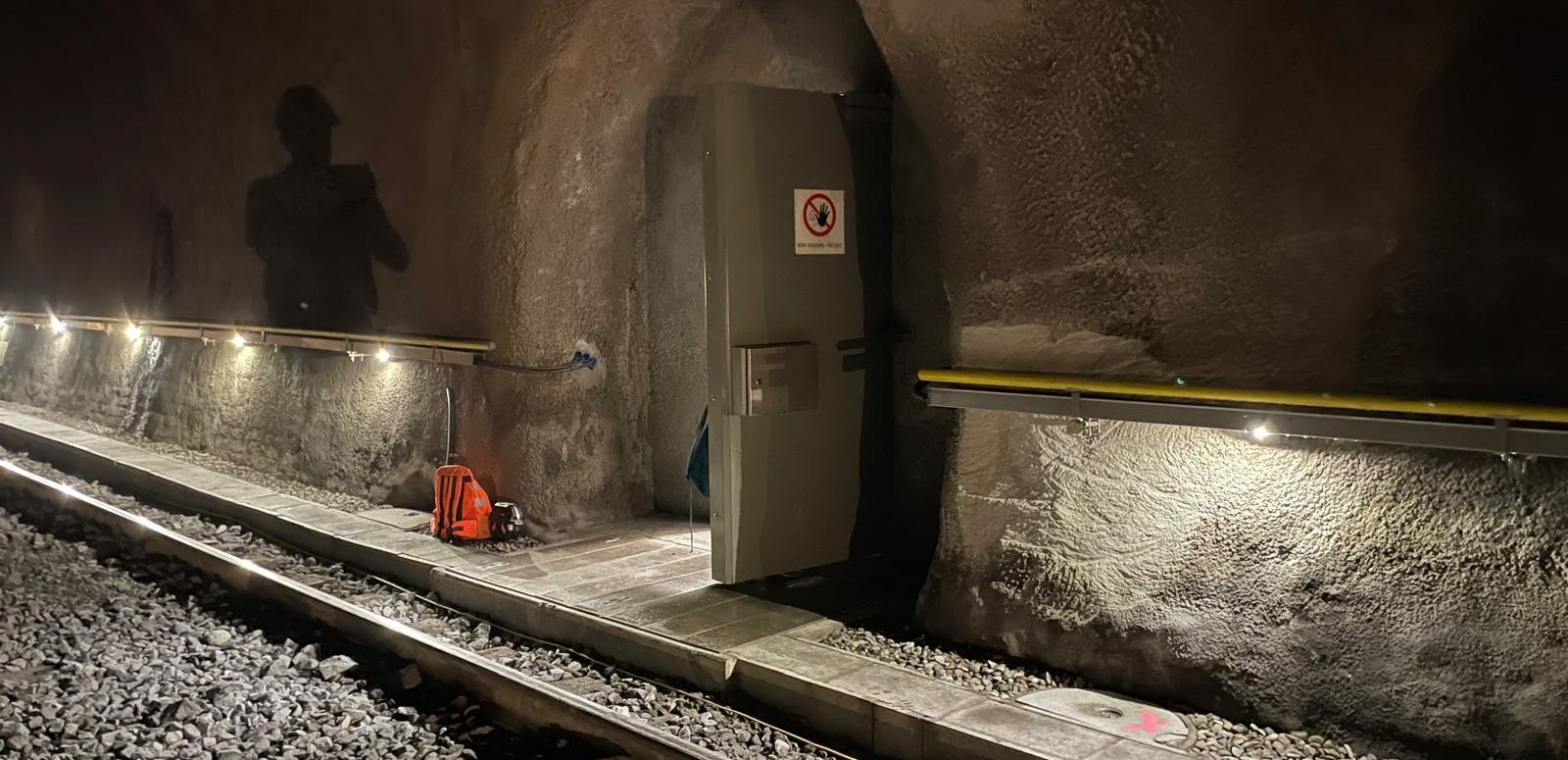

- Renewal of self-rescue systems (handrails, emergency lighting, signage) on the side of track 100, including extension to the open line up to assembly points
- Installation of additional earthing loops
Services
In connection with the above construction works, the contractor provides the following services:
- Preparation of the execution design (Phase 51 according to SIA 103/112)
- Site supervision (Phase 52 according to SIA 103/112)
- Commissioning and project close-out (Phase 53 according to SIA 103/112)
- Coordination of SBB services during the execution design and construction phases
- Provision of logistics and ensuring safety in the tunnel for SBB services and third-party contractors
Key Personnel
- Overall Project Manager: Lukas Herburger
- Head of Design – Cables & Technical Systems: Michael Krös (Epro Traffic)
- Head of Construction – Civil Works / Tunnel Works: Marco Würsch / Michal Szymanski
- Head of Construction & Commissioning – Cables and Technical Systems: Marsel Sljivo
- Head of Track Works: Ramazan Sönmez
- Site Management & Overall Coordination: Melissa Preschan
- Construction Manager – Civil Works External Areas: Marco Würsch
Special Features
- All construction works are carried out by internal companies of the Rhomberg Sersa Rail Group; exceptions are slipform works in the ventilation shaft and waterproofing works
- Refurbishment of a 134 m high vertical ventilation shaft
- Obtaining various approvals from the Federal Office of Transport (BAV) and SBB for combined vehicle-machine operations
Construction Under Operation
All works – except for the turnout replacement in the crossovers – are carried out while maintaining 24-hour railway operations on the adjacent track (track spacing 3.6 m). Construction works are limited to night-time possessions (typically 23:00–06:00) on the construction track. During daytime, both tracks in the tunnel remain fully operational.
Innovation in the Hauenstein Tunnel

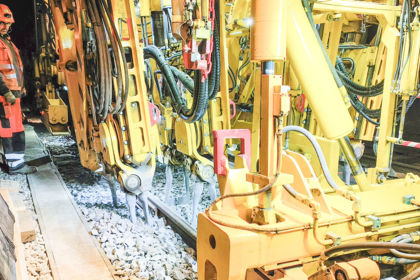

The “zero tamping” as a new milestone – precision, teamwork and efficiency in rail construction.
Ventilation shaft refurbishment in the Hauenstein Base Tunnel
